Home > Uncategorized > Zero Trim Piling

Zero Trim Piling

As infrastructure become bigger, heavier and more demanding of their foundations, piles are becoming more frequently used to support the projects.  Piles can be either driven (eg. precast concrete or steel sections) or bored (eg. rotary bored, continuous flight auger, full displacement) into the ground depending on requirements for the finished pile and any restrictions or limitations on construction methodology.  Bored piles are often filled with a polymer or bentonite fluid to support the open excavation before steel reinforcement bars (re-bar) is lowered in and concrete is poured into the excavation.

When a pile is cast, the concrete at the top layer is contaminated with polymer or bentonite fluid that’s used to retain granular material and support the excavation.  The concrete is over poured above the cut off level (COL) and then after curing is removed leaving the re-bars exposed to act as starter bars for the structure or capping beam being constructed above.  The adoption of a suitable pile breaking method can result in financial and programme savings and most importantly will address and reduce potential health and safety issues in relation to this phase of the works.

Traditionally this task of breaking out the concrete above the COL was done with a breaker or jackhammer, with operatives carefully trying to break out just the contaminated concrete and not damage the re-bar or good concrete below the COL.  Other established methods use a pile cropper mounted on a 3600 excavator or high pressure water to remove the concrete above the COL.

The traditional method has health and safety risks associated with HAVS, confined space work, silicosis and working at height.  Using a pile cropper eliminates some of these risks but still creates dust and risks damage to the concrete below the COL or the steel starter bars and using high pressure water requires specialist equipment and contractors onsite.

The “zero trim” pile technique that has been trialled and will be used by SCS JV for contiguous piles in Area East and D-walls in Area Central involves the use of a vacuum excavator (vac-ex) to immediately suck up the over poured, contaminated concrete down to cut off level before curing.  The pile is then backfilled with shingle and the vacuumed concrete recycled.  This has benefits in time, cost and quality as well as health and safety – over the 750 contiguous piles in Area East it is expected to save 60,000 working hours breaking piles and save over £374k of costs associated with pile cropping.

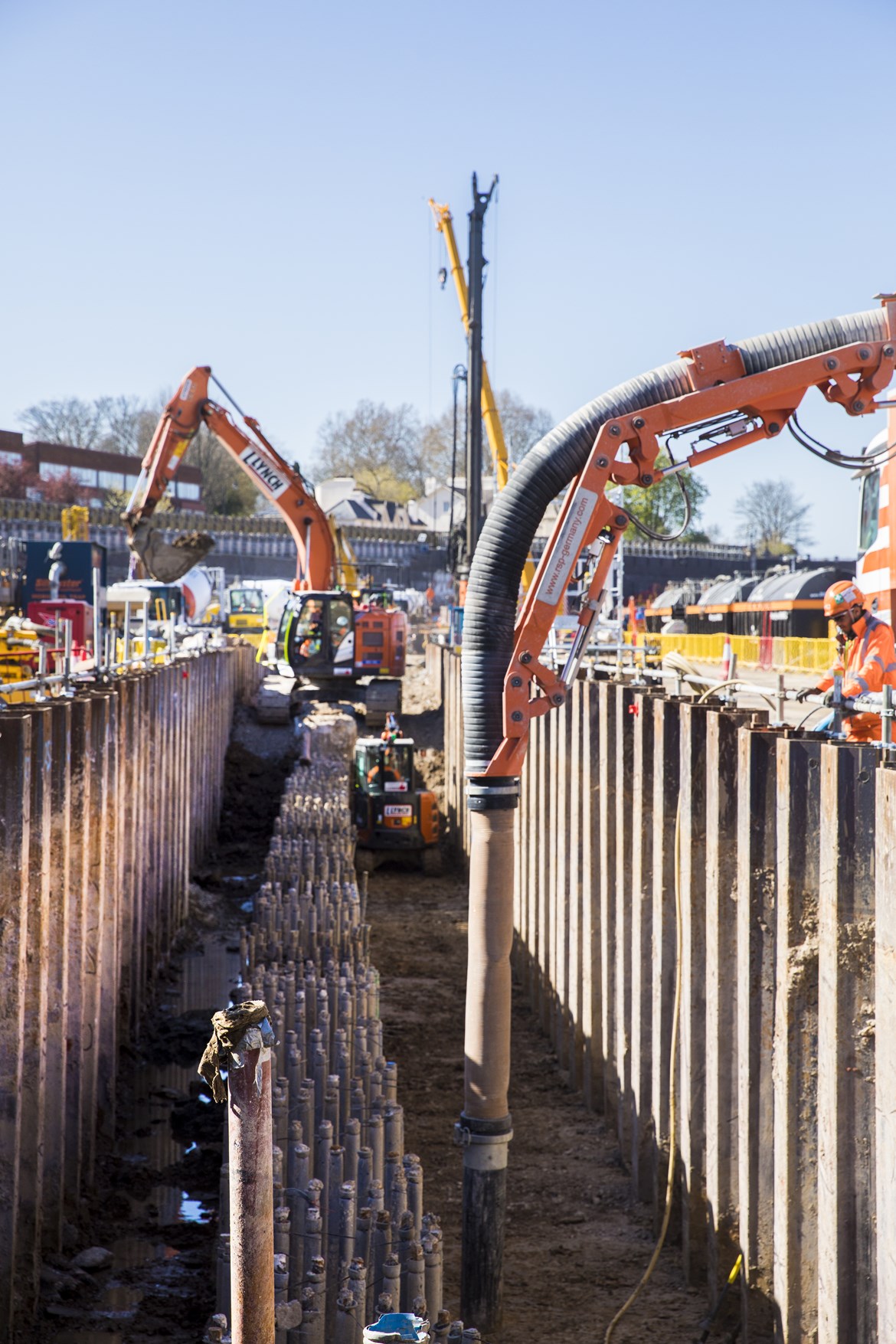

Zero Trim Piling: HS2's contractors, SCS and Skanska Cementation, have developed a new piling method which vacuum excavates piles - reducing health and safety risks, noise, man hours, and project costs. It is a world first innovation that has the potential to change how piling is done in the future.

Tags: Piling, Innovation

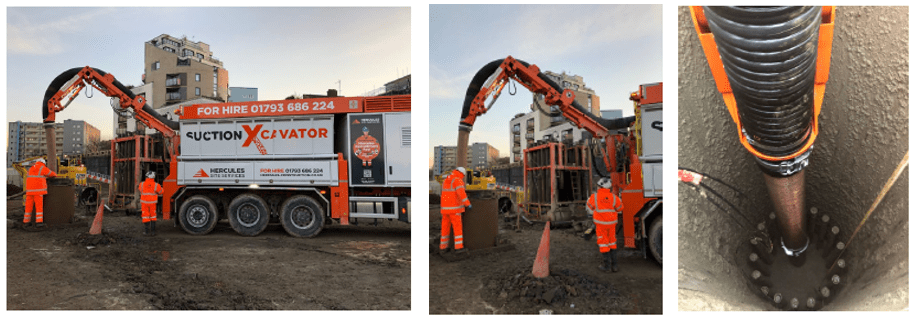

Zero trim method in progress

Methodology

The pile is drilled as normal under the support of bentonite or polymer support fluid.  Reinforcement cages are lowered into place as required.  Tremie pipes are lowered into the pile and concrete poured through them to fill the pile from the bottom up with the support fluid being taken away for treatment and reuse.  The concrete is poured above the cut off level (COL) as the top layer of concrete will be contaminated with the fluid.  The vac-ex is used to take the excess concrete and fluid mix away and reduce the level to the cut off level, exposing the re-bar to be used as starter bars.  If required (generally for tension piles where the COL is a long way below ground level) the casing is then filled with shingle and removed.

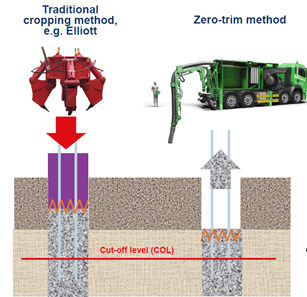

Traditional vs zero trim method
Zero trim method in progress

Benefits of Zero Trim Piling

  • This technique removes the need for any work that will cause HAVS, silicosis or confined space work.  There is no noise from breaking the concrete out however the vac-ex is noisy and PPE as well as collective noise barriers can be used to mitigate this risk.
  • The vac-ex is compact and can fit onto any site where a concrete wagon will discharge and its small boom allows it to operate close to site boundaries (including ones with restrictions such as Network Rail (NR) boundaries without additional restrictions in place.
  • There are significant carbon savings in the technique as the over pour is less than with traditional methods.  For the 1,140 piles in Area East of the SCS JV work on HS2 it is estimated there will be a saving of 820,000 kg of carbon dioxide emissions.
  • There are further positive benefits, including noise reduction which is important for projects like HS2 where construction is taking place within communities and near operational businesses. There are also considerable cost savings and environmental benefits as the new technique uses less concrete, reducing carbon.  On the SCS sites the extracted concrete is being retained on site and being reused in construction elsewhere.  This reduces carbon in construction, including through reduced lorry movements to and from site.

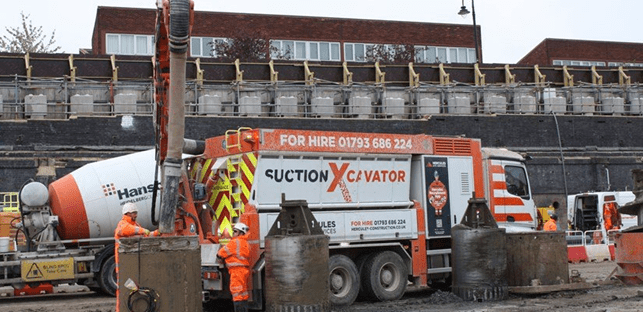

Zero trim method in progress

Trials of the method have been completed and the concept proved. Further data proving the quality and refining the method are ongoing on both temporary and permanent works for SCS on HS2.

I’ve anecdotally been old this method has been trialled in other parts of the world but have not been able to find any literature to evidence it.  As far as we are aware at SCS this method hasn’t been used in the UK ever.  If anyone can shed any light or knows otherwise please let me know.

Further information can be found in various media articles in the comments and if anyone is interested in more details I can send you a TMR on the topic.
